secretSauceSkills


Secret Sauce Skills Project Management




Context

Secret Sauce is Spoon University's online dashboard where members can manage their local chapters, publish content, receive analytics and access Skills training. Each new member must complete their position’s Skills training before unlocking access to the CMS portion of Secret Sauce. It’s the very first step to joining the Spoon community.

problem

Every year, Spoon HQ conducts an annual "revamp" of the Skills section. However, the process is often fraught with delays, miscommunication and heavy last-minute QA work from the project manager. More importantly, the content does not always successfully train students.

my role

In 2017, I led the Secret Sauce Skills revamp with two goals: improve the Skills content itself, and build a better revamp process that is timely, efficient and has everyone walking away proud of their work. Here I will discuss my project management process and how we ensured successful project delivery.

Timeline
3 months

Categories
Project Management, stakeholder research, content strategy

Role
Project Lead

Collaborators
Sarah Adler (CTO), Leigh Silver (contractor), Skills committee of 7 people




Process

Screenshot 2018-03-06 20.15.41.png




01. Discovery

I began by gathering a list of pain points from the last semester. I had plenty of personal experience to draw from, as I assisted project managing and executing the Skills in the final month of the summer 2016 revamp. I also conducted a series of interviews with my teammates to understand their perspectives.




Problem-goal-tactic Matrix


I combined my pain points research into a problem-goal-tactic matrix to clarify the path moving forward.

 I categorized all of the pain points into three sections:  Operations, Content and System .

I categorized all of the pain points into three sections: Operations, Content and System.



Auditing Past Schedule

Analyzed the previous summer's schedule revealed several issues:

  • The PM created all of the outlines, shutting out content creators from the process.
  • The PM only had 10 days to outline for up to 400 pages of content.
  • Committee members only had 1 week to create first drafts, which consisted of 40+ pages of content.
  • The waterfall schedule made editing a behemoth effort each time.
  • The schedule separated the text and multimedia.
audit



02. Pre-work

I knew from my experience with the previous year's revamp that a lack of pre-work created an inconsistent quality of deliverables and miscommunication. One of my major responsibilities was properly scoping the project and empowering my team to strategize their work.




Building a New Project Roadmap


In order to get an accurate project timeline, we mapped out each needed milestone by several key factors: stakeholder, due date, task, hours necessary and deliverables.

This roadmap became a Google calendar shared with the entire committee.

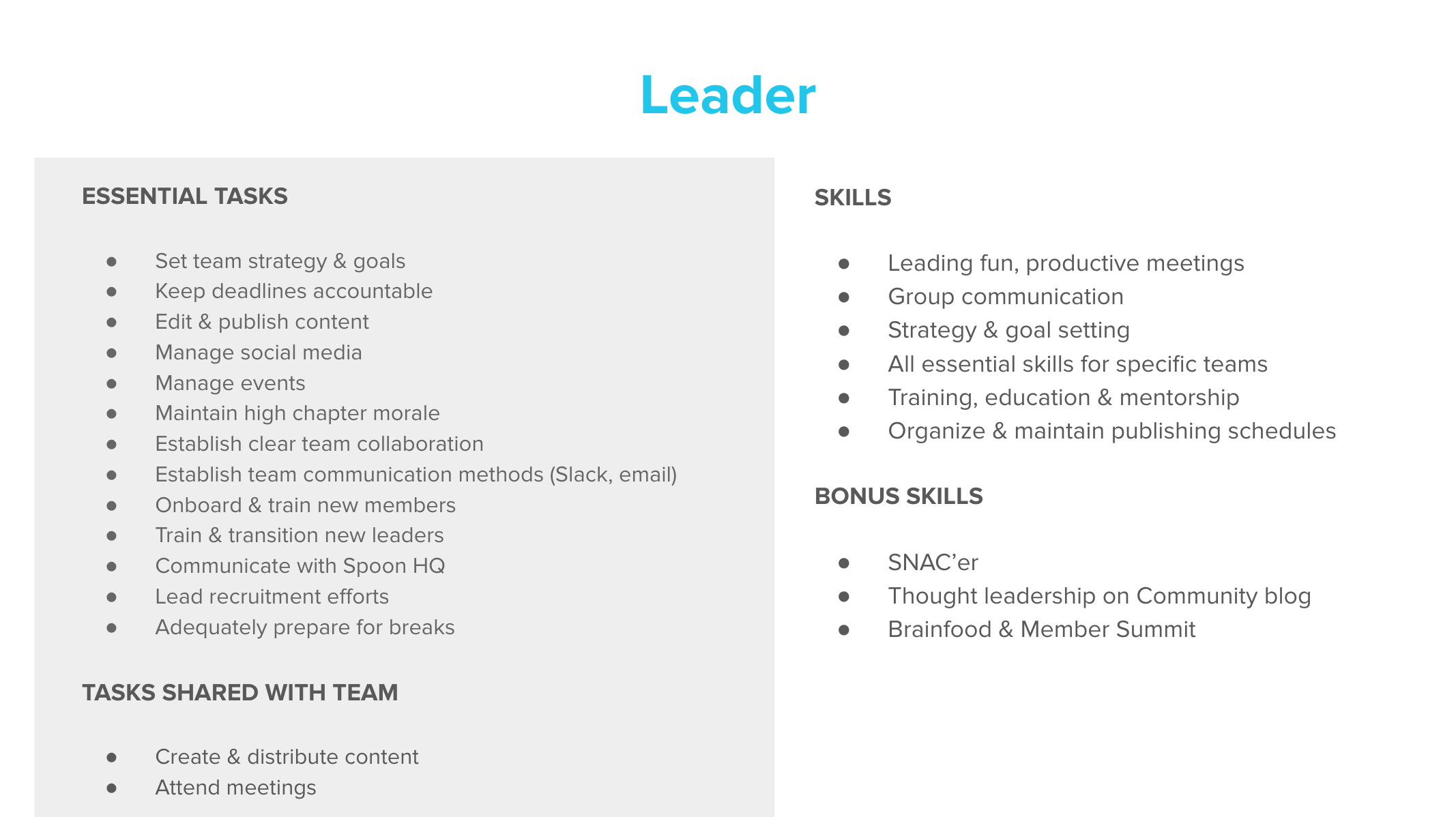

User Archetypes & KPIs


Previously, we did not have clear goals defined for the Skills training.

To help the committee understand the end users' behaviors, abilities and objectives, we created user archetypes for each Position. Defining the KPIs gave us a higher level look into what success for Skills training meant.



3-Step Outline Process

During the last revamp, outlines changed so much that it created a lack of confidence in the process. This time, we designed a very intentional outline process to solve for previous issues.

  • First, brainstorm an ideal outline.
  • Second, audit existing content by Needed Objectives & Outcomes, Page Type, Fundamental-ness, Current Success.
  • Third, bridge the two exercises into a final outline and review with department managers.
Screen Shot 2018-02-23 at 12.25.49 AM.png



03. Content Creation

The biggest issue with content creation was the structure of our work flow. We changed the structure to include frequent, smaller writing and edit sprints. This was more realistic in terms of time required to get the job done, and much more manageable in workload.

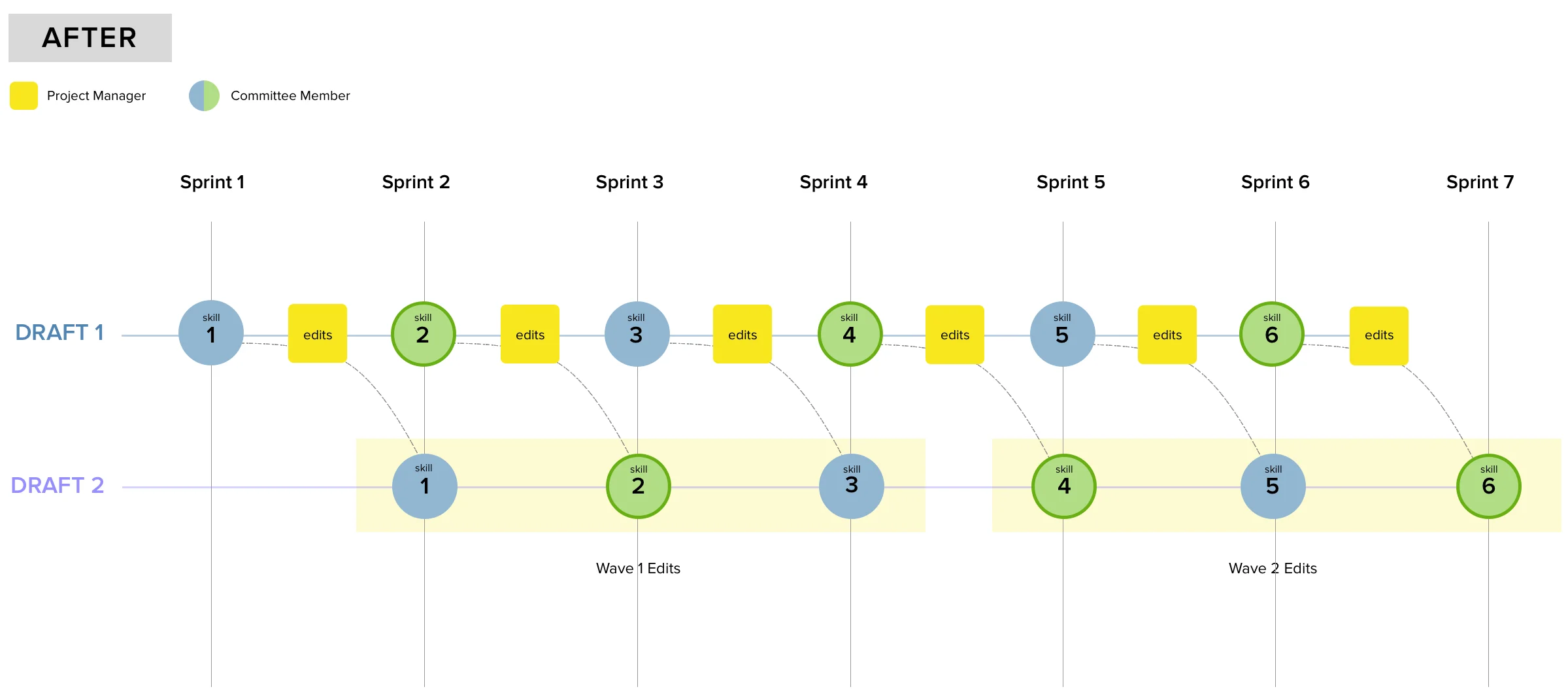

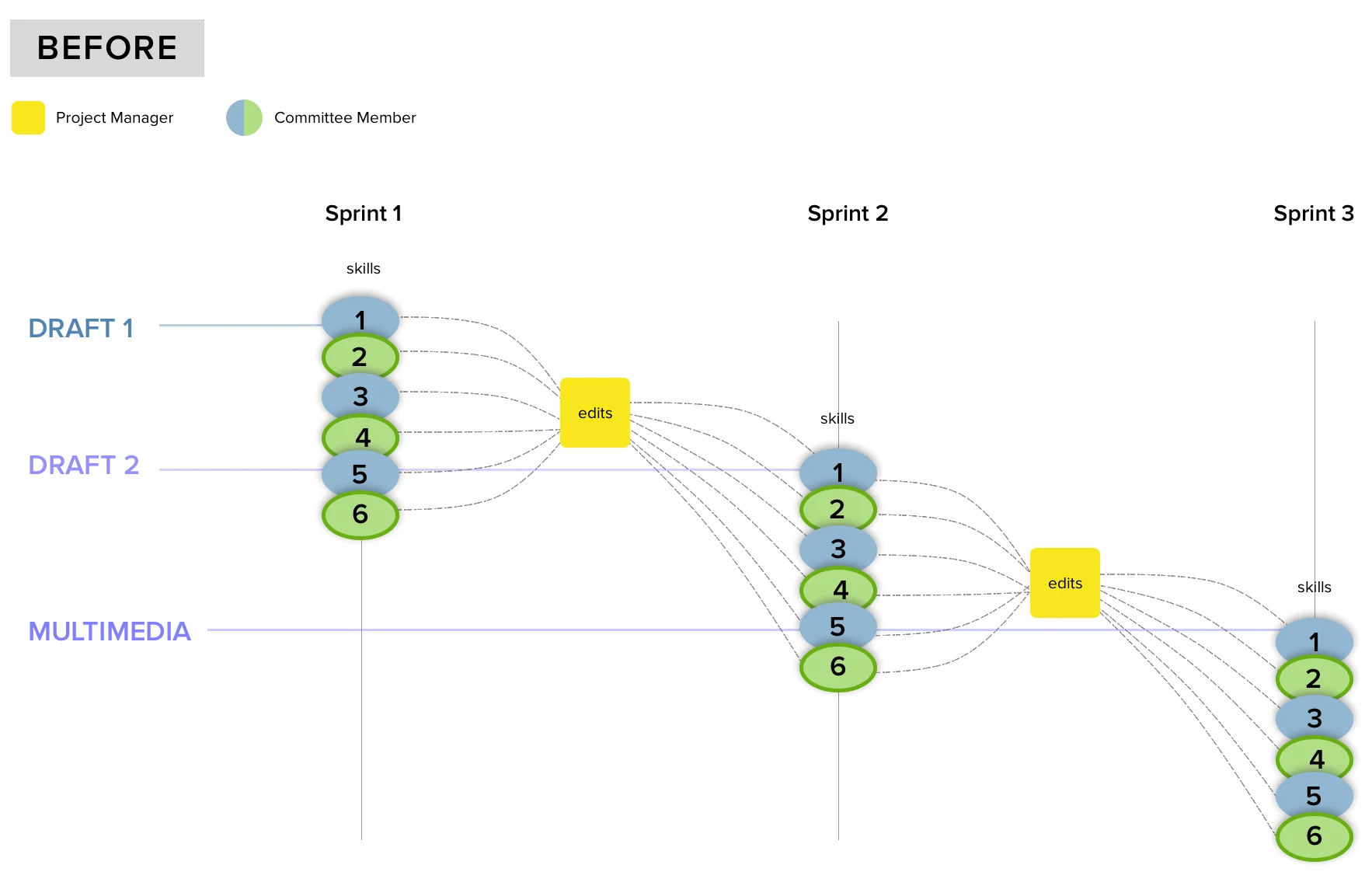

Waterfall Work Flow Agile Work Flow



Before:

  • All 6 Skills per Position half-heartedly created in Sprint 1 due to shortage of time. Started a domino effect.
  • Too much content to edit at once without enough time
  • Separated multimedia and text deliverables.

9 weeks + 3 weeks overtime



After:

  • One Skill per sprint.
  • Create a second draft before moving onto next Skill. Multimedia is incorporated into second draft.
  • 3 Skills = 1 wave. This was an extra layer of preemptive editing to save time later.

14 weeks



Guides & Templates

To create a consistent voice, style and flow, I built a voice and style guide, glossary and page templates that illustrated what the content should look and feel like. This established rules around length, tone of voice and general rules of thumb that also helped me during edits.

guides
